Free concept sizing tool + engineering guide

Custom Drive System Design

Estimate AMR wheel torque, speed and DC demand for custom drive system design. Adjust the example below, then use the guide to plan component validation.

Straight-line powertrain estimate

Wheel torque · steady / peak

27.8 / 120.6 N·m

Per wheel; 2 driven wheels, 1350 kg gross.

DC current · steady / peak

21.0 / 91.0 A

Whole vehicle traction at 48 V nominal; excludes auxiliaries.

Concept assumptions, not component ratings. Straight travel, equal wheel load and clean dry floor only. Safety, thermal performance and dynamic load transfer remain unvalidated. See formulas and limitations.

Mission inputs

30–8000 kg; required.

20–3000 kg; required.

0.2–3.5 m/s; required.

0.3–5 s; required.

0–15 %; required.

100–450 mm; required.

Architecture, traction and environment assumptions

Drive Wheel Count

2 — follows topology.

40–95 %; required.

-25–55 °C; required.

Efficiency and tread coefficients are illustrative constants, not measured supplier properties. Duty and ambient are captured for review; they do not establish a thermal rating.

Estimate details and open checks

Wheel speed

143.2 RPM

At 1.5 m/s. Motor RPM needs the selected gear ratio.

Tractive force · steady / peak

556 / 2412 N

Whole vehicle; grade and acceleration assumed simultaneous.

Mechanical power · steady / peak

834 / 3618 W

Whole vehicle at target speed; wheel output, before drivetrain losses.

Static traction ratio

2.32×

Assumed grip / peak demand; no dynamic weight transfer or turning model.

Grade holding allowance

29.8 N·m/wheel

Chosen 1.5× static grade factor; not a motor brake rating or stopping check. Zero grade still needs a parking review.

Illustrative downhill regen

2509 W peak

Assumed 1.2 m/s² stop. Resistor resistance, pulse energy and BMS acceptance require hardware data.

Engineering validation pending

Thermal feasibility, tread lifetime, stopping distance and scanner protective fields are unknown. Obtain the actual torque/time cycle, derating curves, brake response and worst-case floor tests before releasing the design.

Build the validation plan
Copy the brief, then paste it into Project Summary on the RFQ form.

Design guide · reviewed

Published by AMRDriveUnit. First recorded . Method and source review: every six months, or when cited requirements change. Send corrections through the engineering inquiry form.

Five decisions the estimate can support

Use the tool to establish a concept demand, then close the unknowns below. The focus is complete drive system architecture; mounting details and catalog selection have separate guides.

Separate wheel demand from motor selection

Wheel torque follows force × wheel radius / driven wheels. A motor rating additionally needs reduction ratio, speed, losses and the complete duty trace.

Reproducible method below

Use voltage as an architecture comparison

At equal electrical power, doubling voltage halves DC current. With the same wire resistance, cable I²R loss falls to one quarter. Cable mass and inverter efficiency do not follow automatically.

Explicit equal-power comparison

Treat traction as a measured constraint

The example static grip ratio compares assumed floor friction and wheel load with demand. It does not model pitch, suspension or lateral forces; confirm the worst loaded wheel on the real route.

Assumptions and measurement plan

Validate stopping and energy disposal together

A regen peak does not select a resistor or prove a stop. Check pulse energy, repetition, BMS acceptance and the drive manufacturer limits, then test loaded stopping performance.

Manufacturer method + validation plan

Agree the product scope before documentation

Confirm product classification and placement date. The transition to Regulation (EU) 2023/1230 does not make this concept tool a conformity assessment.

Dated legal source

Mechanical drive assembly guide · AGV drive system selection · Custom AGV and AMR drive unit sourcing

Calculation method, units and assumptions

This is an idealized longitudinal force balance, not an ISO formula or component certification. Let m be payload plus chassis mass in kg; g = 9.80665 m/s²; θ = atan(grade / 100); a = speed / acceleration time; r = wheel diameter in metres / 2; N = driven wheels.

Reproducible sizing equations
OutputEquationBoundary
Steady force (N)Fsteady = m × g × cos(θ) × Crr + m × g × sin(θ)Constant speed on the selected uphill grade
Peak force (N)Fpeak = Fsteady + 1.10 × m × aChosen inertia approximation; constant acceleration and grade together
Wheel torque (N·m)T = F × r / NEqual wheel sharing; motor shaft torque needs reduction ratio
Wheel RPMspeed × 60 / (2 × π × r)No tire compression or slip correction
DC power and currentPdc = F × speed / η; Idc = Pdc / nominal voltageη = assumed transmission efficiency × 0.90 motor efficiency; auxiliary loads and voltage sag omitted
Static grip ratioμ × m × g × cos(θ) × driven share / FpeakFixed assumed friction; no CG transfer, cornering or suspension model
Grade holding allowance1.5 × m × g × sin(θ) × r / NChosen wheel-side allowance; brake location and losses unvalidated
Illustrative regen peak (W)max(0, (1.10 × m × 1.2 − Froll + Fgrade) × speed × η)Example downhill stop; 1.2 m/s² is assumed, not a mandated deceleration

The traction flags below 1.05× and 1.35× are internal review thresholds. A higher ratio does not establish safe performance. Inputs outside the supported domain withhold both results and export.

Demand calculationMass + grade + accelerationWhole-vehicle tractive forceWheel torque + speed demand
Demand calculation: Mass + grade + acceleration → Whole-vehicle tractive force → Wheel torque + speed demand.
Electrical interpretationMechanical traction powerDivide by assumed efficiencyDivide by nominal bus voltage
Electrical interpretation: Mechanical traction power → Divide by assumed efficiency → Divide by nominal bus voltage.

Choose the motion topology before detailed sizing

Engineering comparison, not measured odometry or payload rankings. The tool covers straight travel on conventional wheels only.

Choose the motion topology before detailed sizing
ArchitectureUseful capabilityCost or mismatch to investigate
Differential, 2 driven wheelsStraight travel and spot rotationNo direct lateral travel; pivot scrub and castor drag excluded
Dual swerve, 2 driven wheelsSteered translation in different directionsSteering actuator power, cable routing and calibration excluded
Quad swerve, 4 driven wheelsDistributed driven contactsMore controlled axes; uneven loading can defeat equal sharing
Steered trike, 1 driven wheelSimple steering architectureTurning envelope and available driven load constrain the mission
Mecanum, 4 driven wheelsLateral travel without steering axesRoller vector forces need a different model; calculator output is withheld

Kinematic comparison and declared model boundary; no universal payload band is asserted.

Compare transmission and motor envelopes

Tool efficiencies are illustrative inputs for comparison, not guaranteed performance of a gearbox family.

Compare transmission and motor envelopes
Concept optionEfficiency assumed hereEvidence required before selection
Planetary0.92Ratio, torque-speed map, backlash, bearing load and mounting drawing
Cycloidal0.86Load-dependent efficiency, starting drag, shock limits and lubrication
Hypoid0.89Drive/backdrive losses, mounting orientation and thermal dissipation
Direct drive path0.96 path × 0.90 motorNo reduction advantage; verify continuous torque and hub thermal path

AMRDriveUnit concept assumptions. Missing supplier test curves remain unknown; no shock rating or packaging dimension is inferred.

Compare DC voltage at equal electrical power

Worked comparison at 2,400 W electrical traction demand; current = power / voltage. Actual demand varies with efficiency and battery voltage.

Compare DC voltage at equal electrical power
Nominal busIdeal current at 2,400 WCable loss for the same R, relative to 24 V
24 V100 A1.00×
48 V50 A0.25×
96 V25 A0.0625×

Algebraic comparison, not a cable-sizing table. Select wiring, protection and voltage ratings from actual limits; nominal voltage alone does not establish electrical safety.

Replace assumed grip with route measurements

The model uses fixed illustrative (Crr, friction μ) pairs: NDI PU (0.012, 0.65), standard PU (0.018, 0.55), ESD PU (0.016, 0.58), soft PU (0.024, 0.72). These are not certified material properties.

Replace assumed grip with route measurements
Operating conditionWhy the estimate may failMinimum next step
Clean, dry, straight indoor routeActual wheel and floor may differ from the exampleMeasure drawbar drag and grip at representative loads
Wet, dusty, oily or worn floorAssumed dry friction is inapplicableMeasure a lower-bound coefficient; derate acceleration and grade
Uneven floor or changing payloadStatic driven load share misses wheel unloadingMeasure individual contact loads through the route
Freezer, outdoor or towed trailersCold drag, environment and trailer forces are excludedUse a route-specific model and supplier qualification

Model limitations and proposed measurements. A ratio above 1 does not verify safe traction.

Close thermal and mechanical unknowns

The calculator captures duty and ambient conditions for handoff. It has no winding temperature, RMS load spectrum or fatigue-life model.

Close thermal and mechanical unknowns
UnknownDecision riskValidation evidence
Motor and inverter continuous ratingA short acceleration peak may dominate repeated-cycle heatingTorque/speed/time trace, loss maps and stabilized temperature test
Tread compound and hubLoad, speed and temperature affect deformation and bondingWheel supplier load/speed/temperature data; endurance test
Wheel bearing and axleCantilever moment and floor shocks may dominateIndividual bearing loads, geometry and supplier fatigue calculation
Housing-to-chassis thermal pathA sealed housing may reject insufficient heatMounting contact, interface resistance and worst-ambient validation

Engineering validation checklist. No generic tread blowout temperature, heat-sink thickness or bearing lifetime is claimed.

Keep braking functions and validation separate

The selected brake plan records intent. It does not establish brake capacity or a safety performance level.

Keep braking functions and validation separate
Function or estimateWhat it can tell youWhat remains open
Static grade holding allowanceWheel-side torque using a chosen 1.5× gravity allowanceActual factor, gearbox backdrive, brake location, wear and parking test
Motor controlled decelerationCan return energy into the DC linkAvailable torque under faults, traction, BMS and power loss
STO / safety-related controlsControl safety must be assessed as a systemStopping sequence, required PL, hardware diagnostics and validation
Scanner protective fieldRequires a validated stop and response chainWorst-case measured stopping distance, sensor tolerances and field configuration

ISO public scope supports a design methodology, not universal PL ratings or response times. Use the relevant truck standard and actual device manuals.

Source and scope limitations

Use the regen estimate to request hardware data

Tool output assumes downhill deceleration at 1.2 m/s² and uses the same illustrative drivetrain efficiency in reverse. It is not a prescribed emergency deceleration.

Use the regen estimate to request hardware data
Required inputWhy it mattersAlternative or mitigation
Battery charge acceptance versus state and temperatureThe BMS may limit or interrupt returned energyValidate absorption at full charge and low temperature
Drive clamp voltage and permitted resistor rangeAn arbitrary resistance can overload the chopperFollow the selected drive manual; no resistor ohms are recommended here
Stop time, energy and repetitionPeak watts alone do not establish pulse or average ratingIntegrate braking power over time and verify cooling/duty limits
Failure and mechanical stopping behaviorA resistor does not establish power-loss stoppingValidate the whole braking architecture on the vehicle

Beckhoff demonstrates the distinction between peak and continuous braking power for a specific axis. Obtain the AMR drive manufacturer data for an actual selection.

Source and scope limitations

Choose customization only when the constraint warrants it

Procurement comparison based on engineering judgment. Price, NRE, MOQ, lead time and savings are quote-dependent and currently unknown.

Choose customization only when the constraint warrants it
Decision dimensionCatalog routeCustom route
Early proof of conceptUseful when an existing envelope and ratings fitUseful when catalog constraints block the architecture
Mechanical fitCheck adapters, suspension and service accessSpecify interfaces, load paths and tolerances before releasing CAD
Engineering cost and scheduleConfirm stock, integration work and test availabilityObtain scoped NRE, prototype milestones and validation responsibilities
Production and serviceCheck supply continuity and replacement interchangeabilityAgree tooling ownership, revision control and lifecycle spares

Decision framework only; no universal BOM saving, mass reduction or delivery promise.

Confirm the legal framework and supply scope

Reviewed 2026-10-25. Confirm the actual product classification and placement date with the responsible supplier and integrator. The tool makes no claim that a selected drive is compliant or that a document has already been issued.

Machinery framework transition
FrameworkWhere PCM classification appliesWhat to confirm
Directive 2006/42/EC, before the general transitionArticle 13; declaration of incorporation in Annex II 1.B; assembly instructions in Annex VIApplicability to the supplied assembly and final machine integration responsibilities
Regulation (EU) 2023/1230, generally from 20 January 2027Article 11; EU declaration of incorporation in Annex V Part B; assembly instructions in Annex XITransition provisions, scope, documentation and product placement date

The incorporation route does not demonstrate conformity of the completed robot. Marking obligations under other applicable legislation must be assessed separately; a blanket “no CE” statement is inappropriate.

Three reproducible concept scenarios

Illustrative calculations, not customer deployments or measured outcomes. Each uses the same formulas and declared coefficients as the tool. Changing duty or ambient does not create a validated thermal prediction.

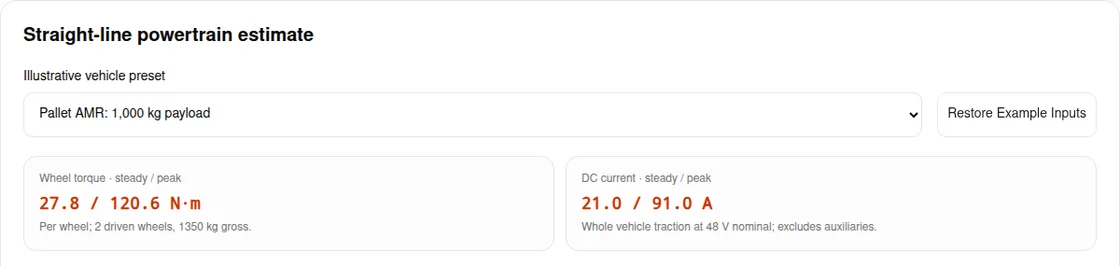

Custom drive system design tool run showing 27.8 / 120.6 N·m wheel torque and 21.0 / 91.0 A DC current for the default pallet AMR
Actual tool execution, captured 25 October 2026. Default pallet example: 1,000 kg payload + 350 kg chassis, 1.5 m/s in 1.2 s, 3% grade, two 200 mm driven wheels, 48 V; planetary efficiency 0.92 × motor efficiency 0.90, NDI PU example, 65% driven load. Continuous duty, holding brake planned, 25 °C. Compact crop of the preset and result; site navigation and floating contact controls are outside the crop. Software evidence only, not measured hardware performance or customer social proof.

Pallet AMR: grade and acceleration together

Inputs: 1000 + 350 kg; 1.5 m/s in 1.2 s; 3% grade; 200 mm wheels; 2 driven wheels; 48 V.

Assumptions: planetary; ndi-vulkollan; 65% static driven load share. All other constants follow the method above.

Steady / peak wheel torque
27.8 / 120.6 N·m
Wheel speed
143.2 RPM
Whole-vehicle DC current, steady / peak
21.0 / 91.0 A

Use the simultaneous grade/acceleration result as a concept demand. Ask for motor torque-speed curves and verify worst-case traction before picking a ratio.

Light AMR: compare 24 V with 48 V

Inputs: 220 + 80 kg; 1.8 m/s in 0.8 s; 2% grade; 160 mm wheels; 2 driven wheels; 24 V.

Assumptions: planetary; standard-pu; 70% static driven load share. All other constants follow the method above.

Steady / peak wheel torque
4.5 / 34.2 N·m
Wheel speed
214.9 RPM
Whole-vehicle DC current, steady / peak
10.1 / 77.4 A

Keeping this same demand and efficiency, changing to 48 V halves estimated bus current. Confirm battery/controller ratings rather than inferring a wire gauge.

Heavy carrier: four driven wheels

Inputs: 2500 + 500 kg; 1 m/s in 1.5 s; 6% grade; 250 mm wheels; 4 driven wheels; 96 V.

Assumptions: cycloidal; high-traction-pu; 85% static driven load share. All other constants follow the method above.

Steady / peak wheel torque
77.1 / 145.8 N·m
Wheel speed
76.4 RPM
Whole-vehicle DC current, steady / peak
33.2 / 62.8 A

Equal load sharing reduces per-wheel demand in this calculation. Measure the least-loaded wheel and add steering demand before accepting a four-module design.

Turn the estimate into a validation plan

Use acceptance criteria agreed for the actual mission and applicable requirements. The following checks define evidence to request, not a ready-made safety approval.

Traction uncertaintyMeasure wheel loads + floor gripRecheck worst route and payloadSet and validate motion limits
Traction uncertainty: Measure wheel loads + floor grip → Recheck worst route and payload → Set and validate motion limits.
Prototype releaseDemand + component dataLoaded thermal and braking testsResolve open checks before release
Prototype release: Demand + component data → Loaded thermal and braking tests → Resolve open checks before release.
Prototype validation evidence
DecisionEvidence to collectMitigation or alternate path
Torque and control sizingTorque-speed map, current logs and actual acceleration at loaded voltageIncrease ratio, relax acceleration or select a larger drive
Traction and stoppingWorst-case load, floor, grade, brake delay and full stopping testsReduce speed/grade demand, change load sharing or brake architecture
Thermal enduranceRepresentative repeated duty at worst ambient until temperatures stabilizeDerate the cycle, improve heat rejection or select a larger continuous rating
Regen and power failureDC-link voltage, BMS behavior, pulse energy and loss-of-power behaviorValidate an energy sink and mechanical stopping/holding strategy
Commercial releaseQuote, NRE, supplier drawings, documented scope and agreed test ownershipUse a catalog prototype if customization has not earned its schedule/cost
Truck safety standard scope

Engineering questions before an RFQ

Sizing and architecture

Does the tool calculate motor torque or wheel torque?

Wheel output torque per driven wheel. Motor shaft torque additionally needs the chosen gear ratio and gearbox efficiency; motor speed and the torque-speed envelope must also be checked.

What does steady torque mean here?

Torque to maintain target speed on the selected grade with the example rolling resistance. It is a mission demand, not a verified continuous motor rating.

Can I size a Mecanum system here?

No. Roller vector forces and direction-dependent losses need a separate model. Selecting Mecanum withholds estimates and export; send the mission and motion directions for engineering review.

How does wheel diameter change the result?

For fixed required force, wheel torque grows with radius. At fixed vehicle speed, wheel RPM falls as diameter grows. Ground clearance, floor joints and the actual tire rolling resistance require separate checks.

Are the tread and gearbox values measured product data?

No. They are explicitly labeled concept assumptions for comparing sensitivity. Replace them with supplier curves and measurements before component selection; no material temperature limit or backlash rating is implied.

Does a favorable traction ratio mean the robot is safe?

No. It only means assumed static grip exceeds the modeled straight-line demand. Dynamic wheel unloading, turns, contamination and local contact differences can invalidate it.

Electrical and thermal

Does 48 V always outperform 24 V?

No. At the same power it halves bus current, and at the same wire resistance cable loss is one quarter. Battery, controller and motor compatibility, voltage excursions, cost and efficiency still need comparison.

Are DC bus current and motor phase current the same?

No. The tool divides whole-vehicle electrical traction power by nominal bus voltage. Phase current depends on torque, motor constants and inverter operation; the tool cannot choose a phase-current limit.

Can the duty setting verify thermal feasibility?

No. It records the intended moving/rest fraction for review. Supply the torque and speed trace, cooling path, losses and temperature limits to validate repeated acceleration and continuous operation.

Does the regen peak select a braking resistor?

No. The selected drive clamp voltage, minimum resistance, current limit, pulse energy, repetition and cooling must be known. Battery absorption and failure behavior are also part of the architecture.

Braking and product scope

Is the 1.5× holding allowance an ISO requirement?

No. It is a chosen concept allowance on static grade torque at the wheel. The final factor and brake rating must follow the application assessment, applicable requirements and supplier data.

Does the page specify a scanner protective field?

No. Field length requires measured worst-case stopping, the full response-time chain and device-specific margins. This page provides neither a certified stopping distance nor a scanner configuration.

Is every drive unit partly completed machinery?

Do not infer classification from a product name or this calculator. Confirm the intended function, supplied assembly and applicable legislation with the responsible supplier and integrator.

When does Regulation (EU) 2023/1230 generally apply?

Its general application date is 20 January 2027, with some provisions applying earlier. Check the placement date, transition provisions and actual product scope. Do not treat a reference to the future framework as a current certification.

Handoff and procurement

What should I send with the exported brief?

Add CAD envelope, actual wheel loads, floor and grade measurements, torque/speed/time duty trace, voltage range, control interface, quantity and validation requirements. Thermal and safety unknowns remain listed in the brief.

What if the calculator or clipboard is unavailable?

Restore example inputs or correct the highlighted fields. For unavailable Mecanum sizing, send your mission profile for review. You can manually select the valid brief, email it, or use the contact RFQ form; without JavaScript the default example and guide remain readable.

Sources, review date and evidence boundaries

Reviewed 2026-10-25. Public standard summaries support their scope only; they are not evidence of clause-specific thresholds or certification of this tool. Numerical coefficients and scenarios are labeled engineering assumptions. No customer field-test evidence is claimed.

ISO 3691-4:2023

Public scope: driverless industrial truck safety and verification. The catalog entry does not substantiate the previous fixed braking, scanner margin or muting numbers. Full requirements must be checked for the application.

Open primary source

ISO 13849-1:2023

Public scope: design and integration methodology for safety-related controls. It does not prescribe a universal required performance level for every application.

Open primary source

Directive 2006/42/EC

For the pre-transition machinery framework, check Article 13, Annex II 1.B and Annex VI when the supplied assembly is partly completed machinery. Confirm scope and placement date for the actual product.

Open primary source

Regulation (EU) 2023/1230

General application from 20 January 2027; some provisions apply earlier. For a product classified as partly completed machinery, consult Article 11, Annex V Part B and Annex XI. A calculator cannot determine classification or demonstrate conformity.

Open primary source

Beckhoff: calculation of a brake resistor

Manufacturer example showing that regenerative peak and continuous power both matter. It is an axis-specific example, not a resistor selection rule for every AMR or an endorsement of this tool.

Open primary source

Request a custom drive system design review

Copy the concept brief above and paste it into Project Summary on the RFQ form. Add your CAD envelope, duty trace, actual floor conditions and quantity. Ask the engineering team to confirm feasibility, documentation and delivery scope.
